Define Custom Board and Reference Design for Zynq Workflow
This example shows how to define and register a custom board and reference design in the Zynq® workflow.
Introduction
You can register the Digilent® Zybo Z7-10 Zynq development board and a custom reference design in the HDL Workflow Advisor for the Zynq workflow.
This example uses a Zybo Z7-10 Zynq board, but you can define and register a custom board or a custom reference design for other Zynq platforms.
Requirements
Xilinx Vivado Design Suite, with supported versions listed in the HDL Language Support and Supported Third-Party Tools and Hardware
Digilent® Zybo Z7-10 Zynq™ development board with the accessory kit
HDL Coder Support Package for Xilinx Zynq Platform
Embedded Coder Support Package for Xilinx Zynq Platform
Note: This example uses Digilent® Zybo Z7-10 Zynq-7000 ARM/FPGA SoC trainer board. This example can be used as reference to create Zybo Z7-20 Custom Board and Reference Design.
Set Up the Zybo board

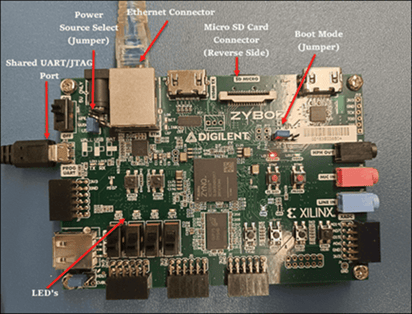

To become familiar with the features of the Zybo board, see the Zybo Z7-10 Board Reference Manual.

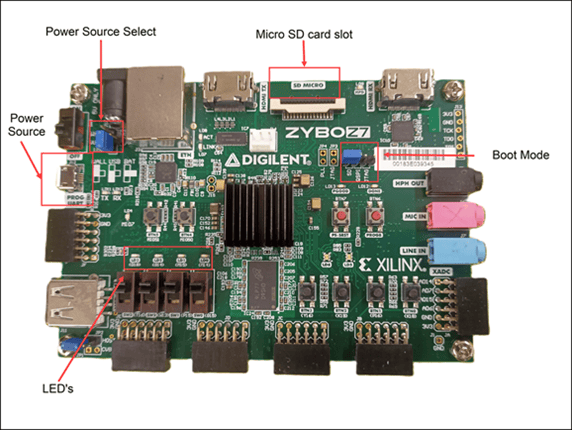

1. Set up the Zybo Z7-10 board.
2. Ensure that you have properly installed the USB COM port device drivers on your computer.

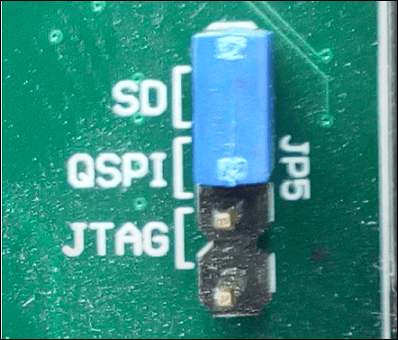

3. Configure the JP5
boot mode jumper to enable the loading of a Zynq Linux image from a microSD card connected to connector J4
.

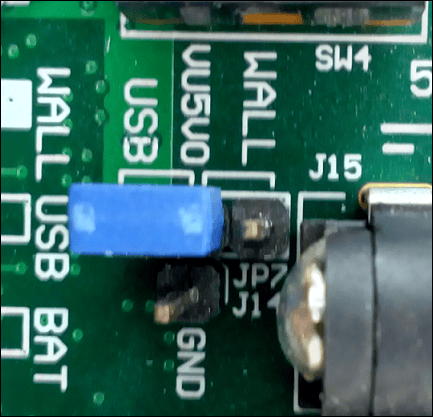

4. Configure the JP7
power source select jumper to use USB as the power source.
5. Connect the shared UART/JTAG USB port on the Zybo board to your computer.
6. Connect the Zybo Z7-10 board to your computer by using an Ethernet cable. The default Zybo IP address is 192.168.1.110
.
7. Download the Zybo Zynq Linux image, extract the Zip archive, and copy the contents to the microSD card. Insert the microSD card in connector J4
.
8. Set up the Xilinx Vivado tool path by using this command:
hdlsetuptoolpath('ToolName', 'Xilinx Vivado', 'ToolPath', 'C:\Xilinx\Vivado\2020.2\bin\vivado.bat');
Use your own Xilinx Vivado installation path when executing the command.
9. Set up the Zynq hardware connection by using this command:
h = zynq();
Register the Zybo Board in Xilinx Vivado tool
By default, Vivado 2020.2 tool does not have the Zybo board files pre-installed. Download these board files from the Digilent website. Unzip the content and navigate to the installation folder of Vivado. Copy the updated Zybo board files to Xilinx Vivado tools.
C:\Xilinx\Vivado\2020.2\data\boards\board_files
The Zybo board part is added to list of development boards while creating Vivado project specific to board.
Note: If the preceding link is unavailable, get the Zybo board files from the Digilent website.
Create and Export a Custom Reference Design by Using Xilinx Vivado

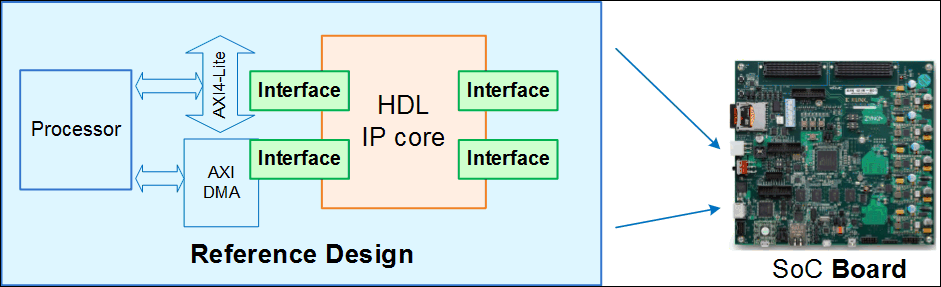

A reference design captures the complete structure of an SoC design, defining the different components and their interconnections. The HDL Coder SoC workflow generates an IP core that integrates with the reference design, and is then used to program an SoC board. This figure shows the relationship between a reference design, an HDL IP core, and an SoC board.
To create and export a simple reference design by using the Xilinx Vivado IP Integrator environment, follow these steps. For more information about the IP Integrator tool, refer to Xilinx documentation.

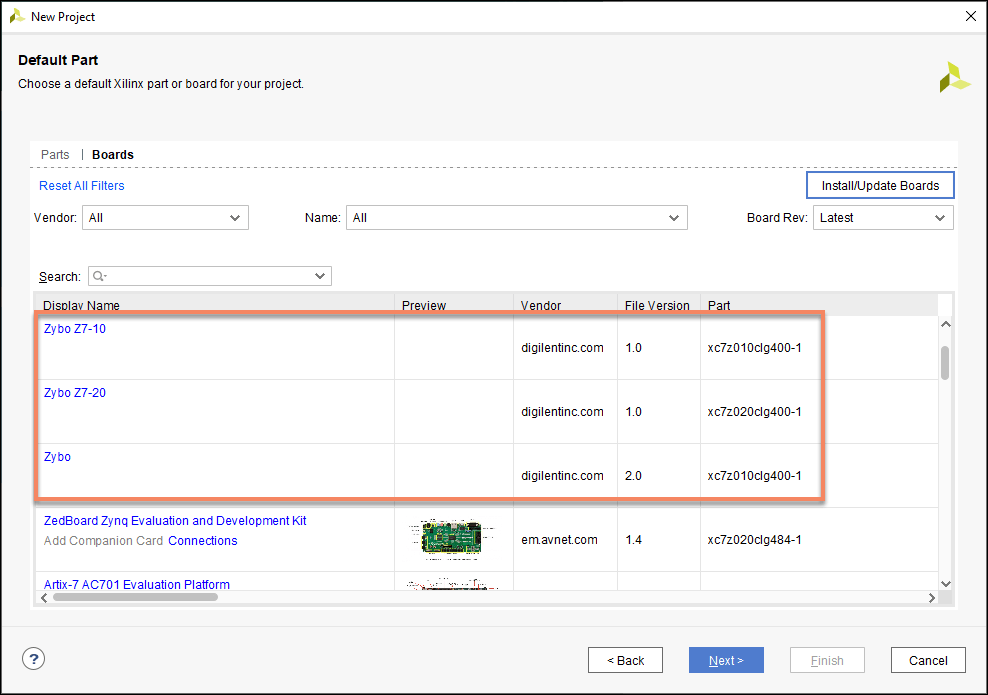

1. Create an empty Xilinx Vivado RTL project by using board part Zybo Z7-10
as the default board.
2. Create an empty block design and add the ZYNQ7 Processing System

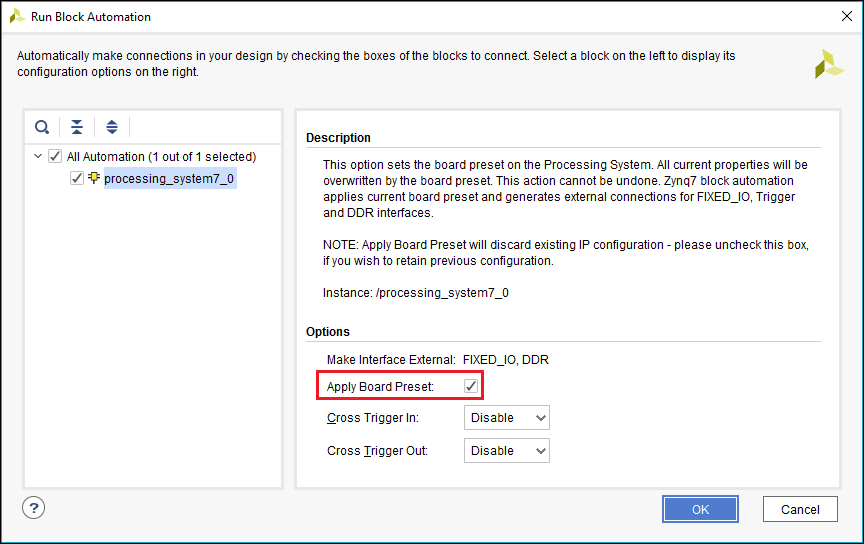

IP block. Run block automation to set a board preset for Zybo Z7-10, which contains the parameters for ZYNQ7 Processing system IP related to MIO Configuration, Clock configuration, and DDR Configuration.
The MIO peripherals are been marked in accordance with the Zybo board definition as the result of applying a board preset.

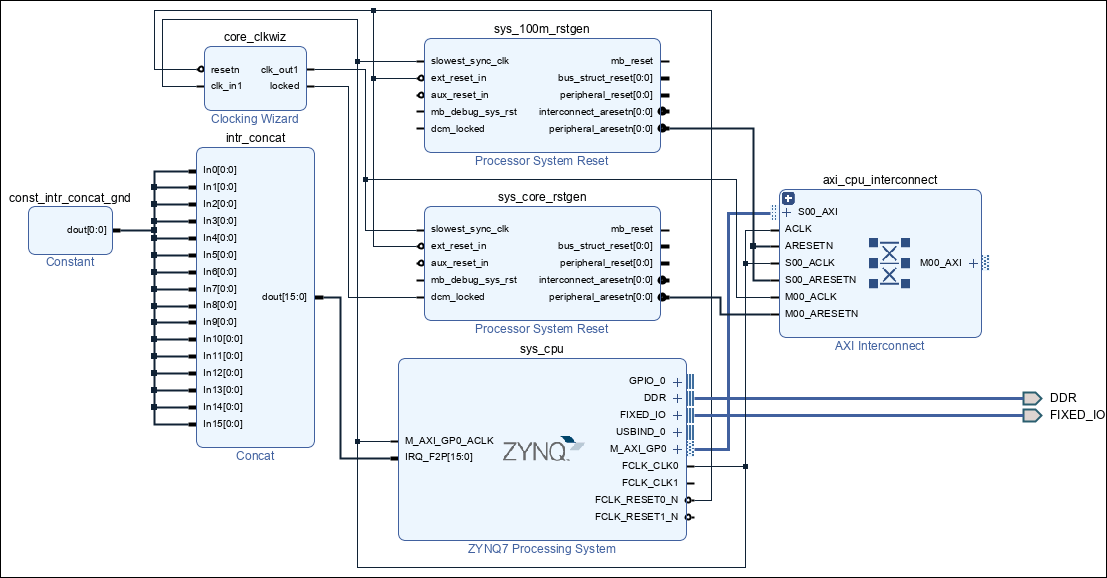

3. Complete the block design.
Notice that the block design does not contain any information about the HDL IP core.
4. Export the completed block design as a Tcl script design_led.tcl

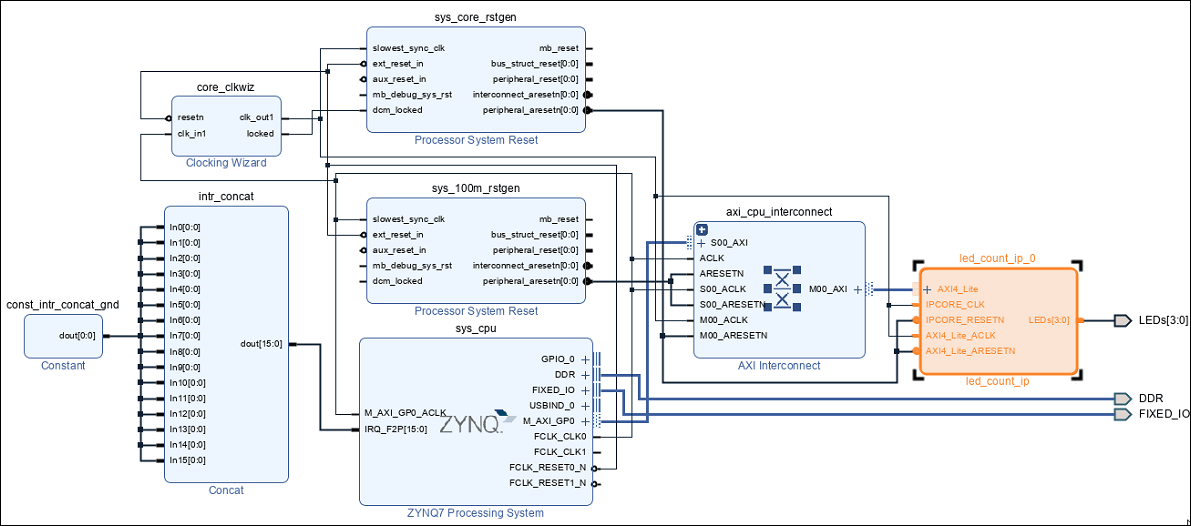

as shown in the following figure:
The exported Tcl script (design_led.tcl
) constitutes the custom reference design. The Tcl script is used in the HDL Coder SoC workflow to recreate the block design and integrate the generated HDL IP core with the block design in a Xilinx Vivado project.
Register the Zybo Z7-10 Board in HDL Workflow Advisor
Register the Zybo Z7-10 board in HDL Workflow Advisor.
1. Create a board registration file with the name hdlcoder_board_customization.m
and add it to the MATLAB path.
A board registration file contains a list of board plugins. A board plugin is a MATLAB package folder containing a board definition file and all reference design plugins associated with the board.
This code describes the contents of a board registration file that contains the board plugin ZyboZ710Registration
to register the Zybo board in HDL Workflow Advisor.
function r = hdlcoder_board_customization % Board plugin registration file % 1. Any registration file with this name on MATLAB path will be picked up % 2. Registration file returns a cell array pointing to the location of % the board plugins % 3. Board plugin must be a package folder accessible from MATLAB path, % and contains a board definition file
r = { ... 'ZyboZ710Registration.plugin_board', ... }; end
2. Create the board definition file.
A board definition file contains information about the SoC board.
This code describes the contents of the Zybo board definition file plugin_board.m
that resides inside the board plugin ZyboZ710Registration
.
Information about the FPGA I/O pin locations ('FPGAPin'
) and standards ('IOSTANDARD'
) is obtained from the Zybo master constraints file from the Digilent website.
The property BoardName
defines the name of the Zybo Z7-10 board as ZYBO Z7-10
in HDL Workflow Advisor.
function hB = plugin_board() % Board definition
% Construct board object
hB = hdlcoder.Board;
hB.BoardName = 'ZYBO Z7-10';
% FPGA device information hB.FPGAVendor = 'Xilinx'; hB.FPGAFamily = 'Zynq'; hB.FPGADevice = 'xc7z010'; hB.FPGAPackage = 'clg400'; hB.FPGASpeed = '-1';
% Tool information hB.SupportedTool = {'Xilinx Vivado'};
% FPGA JTAG chain position
hB.JTAGChainPosition = 2;
%% Add interfaces % Standard "External Port" interface hB.addExternalPortInterface( ... 'IOPadConstraint', {'IOSTANDARD = LVCMOS33'});
% Custom board external I/O interface hB.addExternalIOInterface( ... 'InterfaceID', 'LEDs General Purpose', ... 'InterfaceType', 'OUT', ... 'PortName', 'LEDs', ... 'PortWidth', 4, ... 'FPGAPin', {'M14', 'M15', 'G14', 'D18'}, ... 'IOPadConstraint', {'IOSTANDARD = LVCMOS33'});
hB.addExternalIOInterface( ... 'InterfaceID', 'Push Buttons', ... 'InterfaceType', 'IN', ... 'PortName', 'PushButtons', ... 'PortWidth', 4, ... 'FPGAPin', {'K18', 'P16', 'K19', 'Y16'}, ... 'IOPadConstraint', {'IOSTANDARD = LVCMOS33'});
hB.addExternalIOInterface( ... 'InterfaceID', 'Slide switches ', ... 'InterfaceType', 'IN', ... 'PortName', 'SlideSwitches', ... 'PortWidth', 4, ... 'FPGAPin', {'G15', 'P15', 'W13', 'T16'}, ... 'IOPadConstraint', {'IOSTANDARD = LVCMOS33'});
Register the Custom Reference Design in HDL Workflow Advisor
Register the custom reference design in HDL Workflow Advisor.
1. Create a reference design registration file named hdlcoder_ref_design_customization.m
containing a list of reference design plugins associated with an SoC board.
A reference design plugin is a MATLAB package folder containing the reference design definition file and all files associated with the SoC design project. A reference design registration file must also contain the name of the associated board.
This code describes the contents of a Zybo reference design registration file containing the reference design plugin ZyboZ710Registration.Vivado2020_2
associated with the board ZYBO Z7-10
.
function [rd, boardName] = hdlcoder_ref_design_customization % Reference design plugin registration file % 1. The registration file with this name inside of a board plugin folder % will be picked up % 2. Any registration file with this name on MATLAB path will also be picked up % 3. The registration file returns a cell array pointing to the location of % the reference design plugins % 4. The registration file also returns its associated board name % 5. Reference design plugin must be a package folder accessible from % MATLAB path, and contains a reference design definition file
rd = {'ZyboZ710Registration.Vivado2020_2.plugin_rd', ... };
boardName = 'ZYBO Z7-10'; end
2. Create the reference design definition file.
A reference design definition file defines the interfaces between the custom reference design and the HDL IP core that is generated by the HDL Coder SoC workflow.
This code describes the contents of the Zybo Z7-10 reference design definition file plugin_rd.m
associated with the board ZYBO Z7-10
that resides inside the reference design plugin ZyboZ710Registration.Vivado2020_2
. The property ReferenceDesignName
defines the name of the reference design as Demo system
in HDL Workflow Advisor.
function hRD = plugin_rd() % Reference design definition
% Construct reference design object hRD = hdlcoder.ReferenceDesign('SynthesisTool', 'Xilinx Vivado');
hRD.ReferenceDesignName = 'Demo system'; hRD.BoardName = 'ZYBO Z7-10';
% Tool information hRD.SupportedToolVersion = {'2020.2'};
% add custom Vivado design hRD.addCustomVivadoDesign( ... 'CustomBlockDesignTcl', 'design_led.tcl', ... 'VivadoBoardPart','digilentinc.com:zybo-z7-10:part0:1.0');

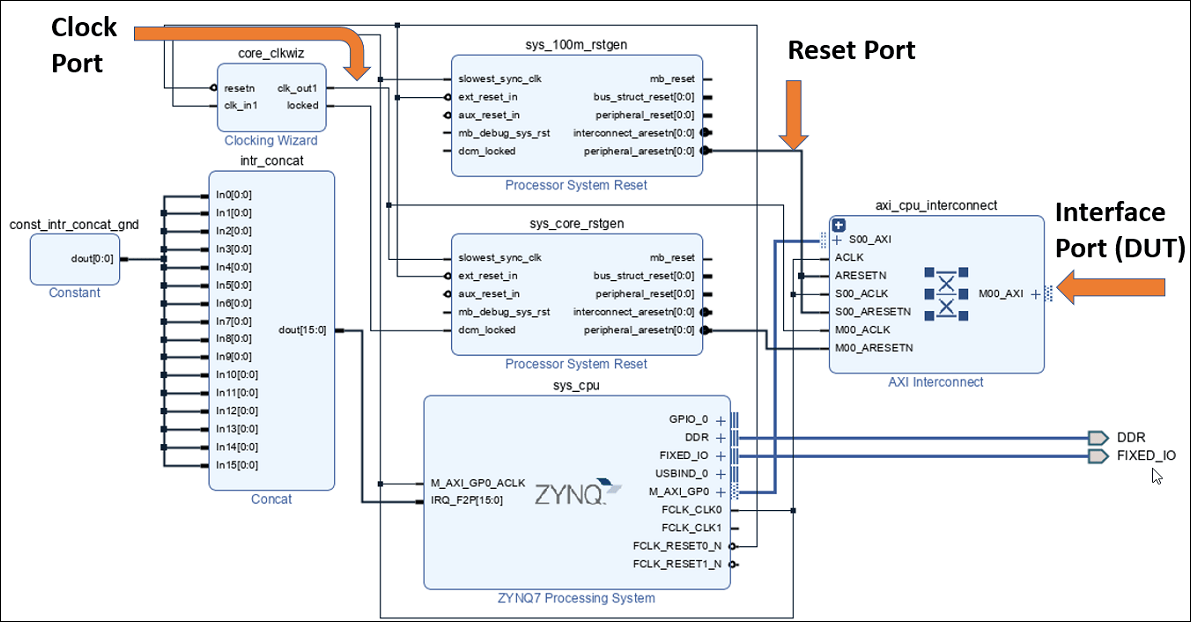

%% Add interfaces % add clock interface hRD.addClockInterface( ... 'ClockConnection', 'core_clkwiz/clk_out1', ... 'ResetConnection', 'sys_core_rstgen/peripheral_aresetn');
% add AXI4 and AXI4-Lite slave interfaces hRD.addAXI4SlaveInterface( ... 'InterfaceConnection', 'axi_cpu_interconnect/M00_AXI', ... 'BaseAddress', '0x40010000', ... 'MasterAddressSpace', 'sys_cpu/Data');
hRD.DeviceTreeName = 'devicetree_axilite.dtb';
A reference design plugin must also contain the SoC design project files.
The Zybo reference design plugin folder ZyboZ710Registration.Vivado2020_2
must contain the Tcl script design_led.tcl
exported previously from the Xilinx Vivado project. The Zybo reference design definition file plugin_rd.m
identifies the SoC design project file through this statement:
hRD.addCustomVivadoDesign('CustomBlockDesignTcl', 'design_led.tcl');
plugin_rd.m
also defines the interface connections between the custom reference design and the HDL IP core indicated by these statements:
hRD.addClockInterface( ... 'ClockConnection', 'core_clkwiz/clk_out1', ... 'ResetConnection', 'sys_core_rstgen/peripheral_aresetn'); hRD.addAXI4SlaveInterface( ... 'InterfaceConnection', 'axi_cpu_interconnect/M00_AXI', ... 'BaseAddress', '0x40010000', ... 'MasterAddressSpace', 'sys_cpu/Data');
Note The 'BaseAddress'
of the AXI4 interface must be a valid address in the 'MasterAddressSpace'
. The address must not create any address conflict with other address-based peripherals in the custom reference design.
Execute the SoC Workflow for the Zybo Board
Use the custom board and reference design registration system to generate an HDL IP core that blinks LEDs on the Zybo Z7-10 board. The required files used are located at:
matlab/toolbox/hdlcoder/hdlcoderdemos/customboards/ZYBO
1. Add the Zybo board registration file to the MATLAB path.
addpath(fullfile(matlabroot,'toolbox','hdlcoder','hdlcoderdemos','customboards','ZYBO'));
2. Open the Simulink model that implements LED blinking.

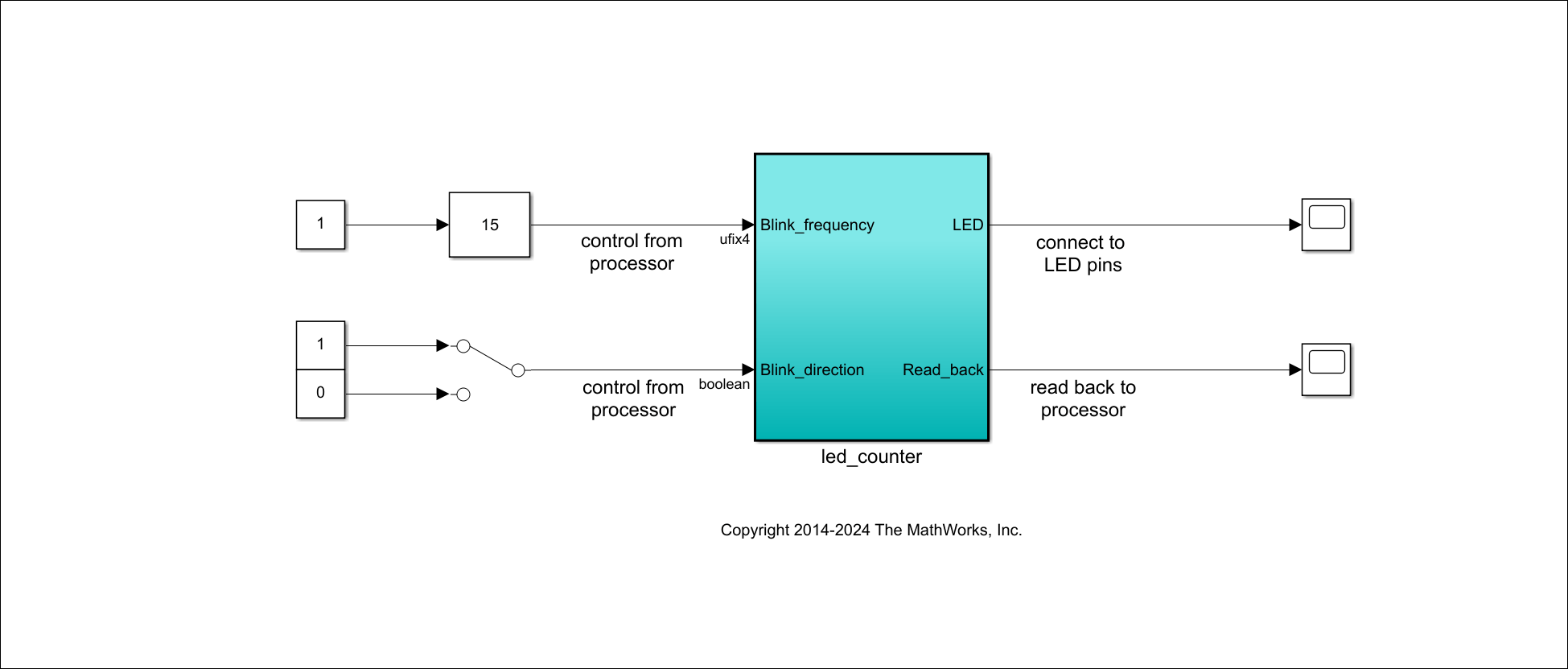

open_system('hdlcoder_led_blinking_4bit');
3. Launch HDL Workflow Advisor from the hdlcoder_led_blinking_4bit/led_counter
subsystem by right-clicking the led_counter
subsystem, and selecting HDL Code > HDL Workflow Advisor. Or, you can click the Launch HDL Workflow Advisor box in the model.
In the Set Target > Set Target Device and Synthesis Tool task, select IP Core Generation for the Target workflow. ZYBO Z7-10
now appears in the drop-down list Target Platform. Select ZYBO Z7-10
as a Target Platform.
4. Click Run This Task to complete the Set Target Device and Synthesis Tool task.
5. In the Set Target > Set Target Reference Design task, the custom reference design Demo system
now appears in the Reference design field. Select Demo system
and click Run This Task.
6. In Task 1.3 Set Target Interface, select the connections, and then click on Run This Task.
7. To generate IP core and view the IP core generation report, follow step 3 and step 4 of Generate an HDL IP core using the HDL Workflow Advisor section of Getting Started with Targeting Xilinx Zynq Platform.
8. To integrate the IP core in the reference design and create the vivado project, follow step 1 of Integrate the IP core with the Xilinx Vivado environment section of Getting Started with Targeting Xilinx Zynq Platform.
9. After completing the Create Project task under Embedded System Integration, examine the Xilinx Vivado project created by the SoC workflow . This figure shows the block design of the SoC project where you have highlighted the HDL IP Core. Compare this block design with the previous block design used to export the custom reference design for a deeper understanding of the relationship between a custom reference design and an HDL IP Core.
10. Follow the steps 2, 3 and 4 of Integrate the IP core with the Xilinx Vivado environment section of Getting Started with Targeting Xilinx Zynq Platform example to generate the software interface model, generate the FPGA bitstream, and program the target device respectively.
11. After loading the bitstream, the LEDs on the Zybo Z7-10 board now start blinking. You can control the LED blink frequency and direction by executing the software interface model on the Zynq ARM processor. Refer to Generate a software interface model section of Getting Started with Targeting Xilinx Zynq Platform example to control the LED blink frequency and direction from the generated software interface model.
